2026年10月4日星期日

Stock vs Custom Hotel Lighting: When the Catalogue Wins

On most hotel lighting packages, stock versus custom is settled line by line rather than once for the building. The bedside pendant, the corridor sconce, the desk lamp, the bathroom mirror light: each is a separate decision, and the person who has to defend it later is usually the procurement lead, not the designer who drew it.

This guide is for that person, and for the owners and designers beside them. It covers where a catalogue fixture wins, what the buyer gives up by choosing one, the hybrid route most projects miss, and the questions that settle the line.

Two boundaries first. Whether a fixture suits a specific room, and whether it meets the compliance regime that applies there, is carried on its own submittal. Final light levels belong to the project lighting designer, working to the standards that apply where the building stands.

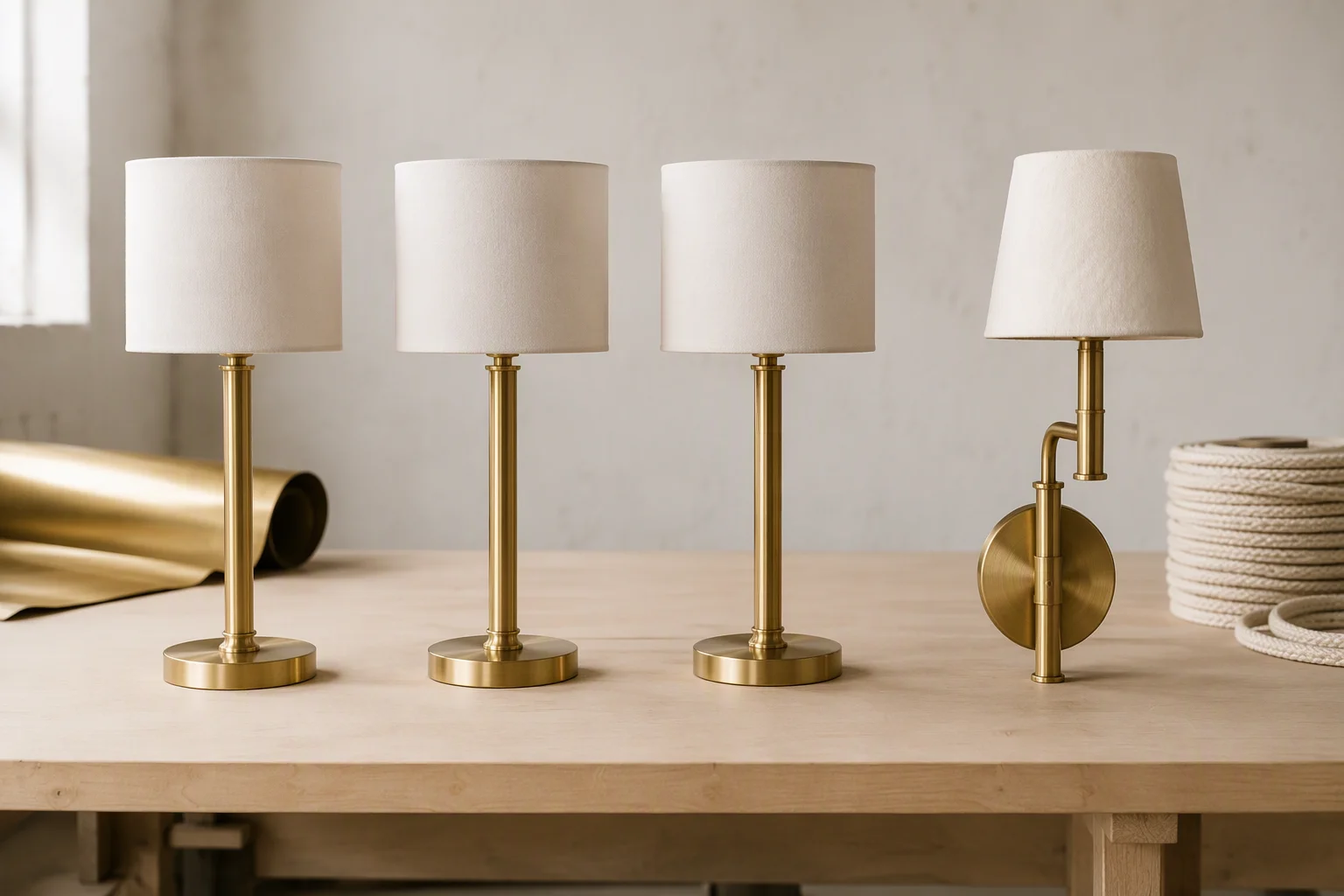

Three identical brass hotel table lamps with off-white shades beside one bespoke brass wall sconce on a workshop bench
Three identical catalogue lamps, one bespoke sconce: the whole argument is which column a line belongs in.

Why the whole schedule should not be written as custom

A guest room schedule is rarely short. Across room types, public areas and back of house, a mid-size property can carry several dozen line items, most of them ordinary: a sconce that lines up with a joinery detail, a table lamp with a fabric shade, a pendant over a bedside table. Writing every one as custom adds three problems that have nothing to do with design quality: each line waits for its own drawing, sample and production slot; a hand-built line is harder to repeat later; and its parts exist only for this order.

The workable split is to reserve custom for the lines where the drawing cannot be met any other way, and to let a catalogue fixture carry the rest. Not "catalogue where it is cheaper", but "catalogue where nothing in the brief requires a new drawing".

Where a catalogue fixture genuinely wins

Read the schedule against the table below, criterion by criterion. Neither column is better; they fail differently, and in different places.

What the project is buyingCatalogue fixtureCustom fixture
Fit to the drawingClosest of the maker's sizesDrawn to the schedule dimension
Time to first unitAgainst stock, in daysAfter drawings, a sample round and a production slot
Change after awardLimited to finish and configurationPossible while the project is still open
Finish controlThe maker's regime, repeated reliablyMatched to a project sample
Repeat phasesDepends on the item staying in the rangeReproducible from the drawing and finish
Spares in year threeStandard parts, tied to the catalogueMade for this order; ask about a spares run
Signature piecesRarely convincing as a lobby one-offThe reason the line exists

Two rows carry most of the weight. Finish control lets a catalogue item sit beside a bespoke one without looking like a different job; repeatability decides whether phase two can be ordered without a conversation.

What choosing catalogue asks you to give up

A catalogue fixture is built to the maker's dimensions, and what the project usually loses is the interface, not the look.

  • Dimensions that round. A stem, arm or projection that lands near the drawing rather than on it, which shows where a fixture meets joinery, mirror or headboard.
  • A fixed interface. Switch position, port type, cable exit and mounting plate are decided by the maker.
  • Shade and diffuser families. Proportions and material follow the range, so a room needing a softer or flatter glow may need a different line.
  • Availability over time. A catalogue item can leave the range, leaving a later phase without an identical replacement.
  • Presence in public areas. The lines a guest looks at closely are rarely the lines a range serves best.

None is fatal, and all are cheaper to accept at specification stage than to find on site. If a line meets joinery, or a guest touches it every night, move it to the custom column rather than hoping the rounding stays invisible.

The hybrid route most projects miss

The choice is not binary. A catalogue body with a project finish, a standard lamp with bespoke shade proportions, a catalogue sconce on a project backplate: each lets a line keep the maker's tooling while the project controls what is seen.

Hybrid works only when specified as such. Four things belong in writing before the order.

  • Which parts of the bill of materials the maker will move, and which stay fixed.
  • How the finished interface is drawn and approved, so the installed fixture matches the submittal.
  • Which finish reference the project holds, so a later phase can be matched.
  • How voltage, plug configuration and any control requirement are confirmed for that line.

A modification is neither a bespoke fixture with the protection of a catalogue version, nor a catalogue item with the flexibility of a bespoke one. Ask which side of that line the modified item sits on.

Five questions that settle each line

Five questions per line take less time than one change order later.

  • Would a rounded dimension be visible? If a fixture meets joinery, a mirror edge or a headboard, the drawing usually wins.
  • Does the line carry an interface the building must match? Switch, port, cable exit and mounting height are interface decisions, not aesthetic ones.
  • How many phases are planned, and how far apart? A line that must reappear in eighteen months argues for a route that repeats.
  • What happens if one unit is damaged in year three? Ask about spares before the order, not after the incident.
  • Is this a line the guest looks at, or one they merely use? Design attention belongs where the eye goes.

If a line fails only the phase and spares questions, a reserve of units may beat a custom run. If it fails the first two, custom is usually the honest answer.

Where custom is genuinely unavoidable

  • Rooms with non-standard proportions: an oversized headboard, a vanity beneath a specific mirror, a suite with a change of level.
  • Fixtures that must integrate charging or controls at a set height or position relative to the bed.
  • Feature pieces sized to one ceiling, where the point is that nothing else looks like them, and finishes that must match a joinery or stone sample across the property.
  • A repeat phase where the original line has left the catalogue and the drawing is the only reference.

Mixing both routes in one property

Most packages end up mixed, and the risk is not the mix. It is that two sources of finish and two sources of spares get managed as though they were one.

The mixed package fails quietly, at the finish, long after the schedule stopped being anyone's problem.

Five habits keep it coherent.

  • Hold one approved finish reference for the property and freeze shades and diffusers early, since they read as a family.
  • Take spares from the same production batch as the installed units.
  • Record in the O&M file which lines were catalogue, which were bespoke, and who made each.
  • Agree in advance how a mid-project substitution is reviewed, so a swapped part is a decision, not a discovery.

FAQ

Can a catalogue fixture be modified to fit our drawing?

Often, within limits. Finish and a limited dimension change are commonly moved; the housing, mounting interface and control gear usually stay. Ask before the order, since an undrawn modification is not protected.

Do we still need a mock-up room if we choose catalogue fixtures?

Yes, though the scope changes. A mock-up proves the interface rather than the piece: mounting height, switch reach, glare from the bed, and whether the item sits beside the bespoke lines in the room.

Will the same catalogue item be available for a later phase?

Not guaranteed. Ranges are revised, and today's line may not be identical in eighteen months. For a line that must reappear, ask its expected shelf life or hold a reserve.

Is custom always the more expensive route?

Not always. The comparison depends on quantity, tooling and finishing more than on the label. Price both routes against the same scope, not on a verbal comparison.

Who should make the call, the designer or procurement?

Both, on different grounds. The designer owns design intent and the interface; procurement owns phase planning, availability and spares. A line only one has signed off will be reopened later.

The takeaway

Catalogue and custom are not competing philosophies; they are two routes with different failure modes. A catalogue fixture buys speed and repeatable finish, and asks the project to accept the maker's dimensions and interface. A custom line buys fit and design control, and asks the project to carry drawings, samples and spares. Decide it line by line, keep custom where a rounded dimension or a fixed interface would be visible, and hold one finish reference across both routes. What keeps a package coherent is somebody writing down which line took which route, and why.

Zerouno Lighting (ZeroUNO) manufactures hospitality decorative lighting in Zhongshan, China. Founded in 2013, the company builds made-to-order wall, table and floor fixtures to project drawings, from a single-piece sample for approval through to production, and works with project teams on the lines a catalogue item cannot serve. Learn more at zerounolighting.com.

About the author

Sonny Yu is Sales Manager at Zerouno Lighting, working with hotel owners, designers and procurement teams on bespoke decorative lighting packages. He writes about specification decisions from the supplier side: which lines genuinely need to be made for a building, and how a package stays coherent when it draws on more than one source.

2026年9月21日星期一

Hotel Lighting RFQ: 18 Details That Prevent Change Orders

An RFQ is the cheapest document in a lighting package, and it decides the most. It is also the one most often written in an afternoon, from a template left over from the last project, with a line that says supply decorative lighting as per drawings.

Change orders rarely arrive because a supplier was careless. They arrive because a question the buyer never answered came back months later as a variation, a re-price or a delay. This guide is for the people who write it: procurement teams and project managers on hotel work. Eighteen details, grouped by what each one protects.

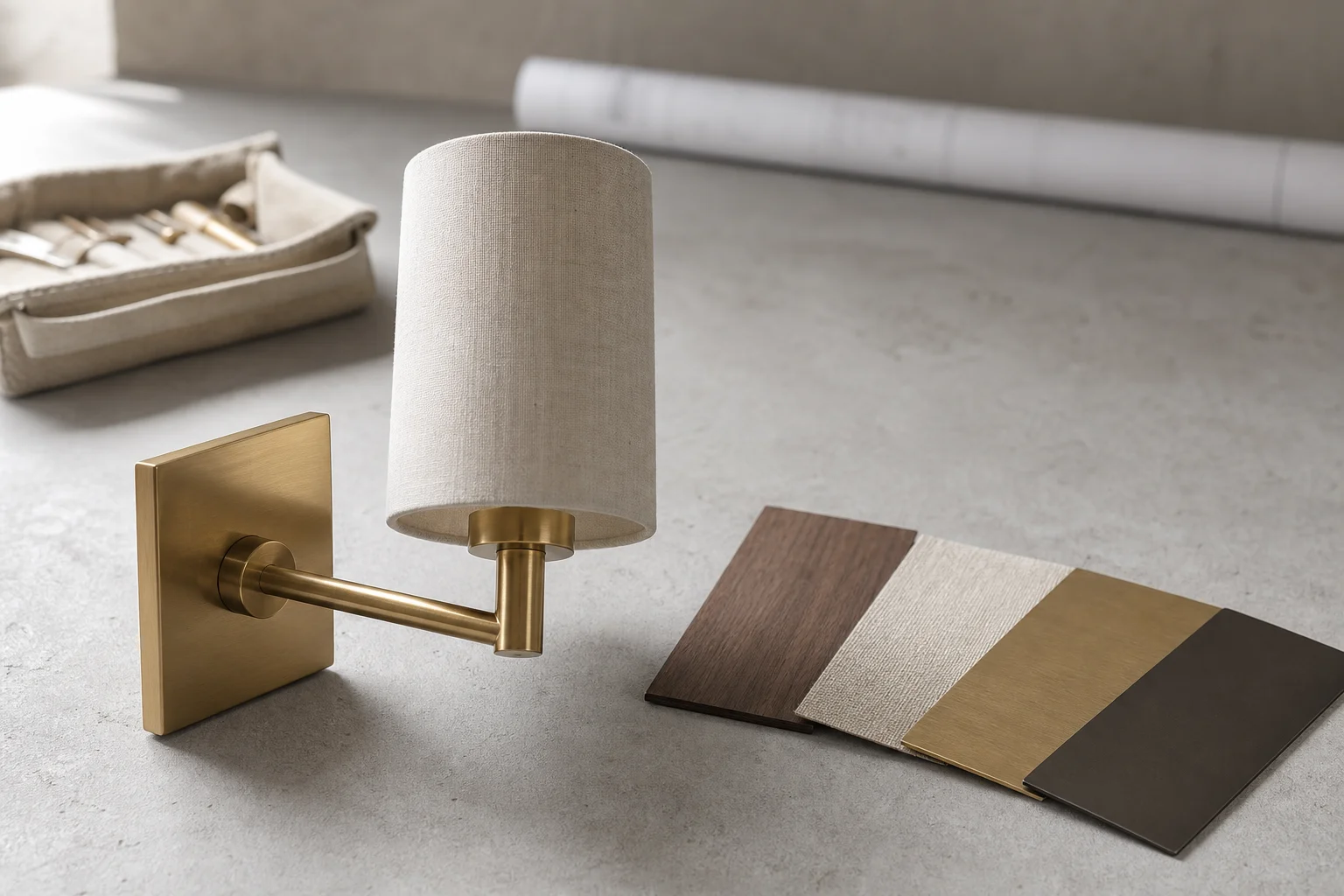

Hospitality wall sconce sample with a linen shade and brass arm beside wood, linen and metal finish swatches
A sample and its finish swatches are the two things an RFQ has to describe precisely, or the order is built on an assumption.

Why change orders usually start in the RFQ

The RFQ is the only document every party works from. The drawing set, the schedule, the finish samples and the commercial terms reach a supplier as attachments, and the RFQ tells them how to read those attachments together. When it is thin, suppliers do not ask. They price the version that protects them.

So five suppliers submit five prices built on five different scopes, and the comparison you expected is not one. The second cost arrives later: once the order is issued, every requirement added after it is a change order, negotiated from the weaker side of the table against a clock that has already started.

The 18 details, grouped by what they protect

The list falls into four groups: scope, technical, commercial and documentation. The grouping is not a filing system; it marks when the cost of leaving a detail out shows up.

#Detail to state in the RFQWhat it prevents later
1Project type and the room schedule, by drawingQuoting a type the project does not have
2Quantity per type, plus the spare allowanceRe-pricing at the first quantity change
3Delivery address and the delivery sequenceFreight and access assumptions that differ
4Target installation window, as a weekOffers built on different lead times
5Who holds the site measurement and the approvalDimension disputes during production
6Fixture family and drawing number from the scheduleSubstitutes quoted against the wrong item
7Finish named by process, not by colour nameA colour that cannot be matched in a run
8Material of every visible partValue engineering after award
9Light source and colour temperature as an agreed rangeSource and driver swaps at approval
10Control interface and the system it joinsControl gear changed after approval
11Wet or exterior zone requirement, per the project teamRe-sealing or replacement on site
12Incoterm, and who clears dutyTwo quotes on two different terms
13Payment milestones and what triggers each oneA dispute over deposit and balance
14Sample and mock-up approval as a gate on productionA run released against an unapproved sample
15Substitution notice as a condition of the orderA swapped component found at handover
16Declarations and test documents by drawing numberA pack that cannot be matched to the schedule
17Pre-shipment inspection and who witnesses itAn inspection claim with no record behind it
18Label, packing and pallet marking to the install sequenceCartons opened to find what is inside

Scope: the five details that decide who is quoting what

Items 1 to 5 are the ones a supplier cannot fill in for you. The room schedule tells them which drawings matter; the quantity per type tells them how much of the job is standard. The delivery sequence is the detail buyers skip most, and it changes freight: a single drop to a loading dock and a floor-by-floor release are different jobs.

Name who holds the site measurement. If the buyer measures and the supplier fabricates, the tolerance belongs to the buyer, and that should be known before approval rather than after a fixing does not line up.

Technical: the six details that decide the price

Items 6 to 11 are what the price is built from. A fixture family named loosely invites a substitute with the same look and a different build. A finish named as antique brass describes an appearance; named by process, it describes something repeatable across a run and across later project phases.

State the material of each visible part, because the parts you cannot see are where a quote is quietly reduced. Light output and colour temperature belong on the page as a range agreed with the project lighting designer: a change after approval reaches back into the driver, the source and the testing. The control interface is the same argument: the system the fixture joins is a technical fact, not a preference. Where a fixture sits in a wet or exterior position, the zone requirement comes from the project team, and the supplier answers it with construction.

Commercial: the four details that decide the schedule

Items 12 to 15 belong in the same document as the technical list, because they decide how the order behaves after it is placed. An RFQ that does not name an Incoterm gets replies on different terms, and the lowest number may be the one that excludes the most. Payment milestones are clearer when each names its trigger: deposit, sample approval, pre-shipment and delivery.

Two of these are gates rather than terms. Sample and mock-up approval should hold the production release, so no run starts against an unapproved sample. Substitution notice should follow the project into its later phases, since a component re-sourced in month nine still has to match what the earlier phase received.

Documentation: the three details that decide acceptance

Items 16 to 18 decide whether the goods are accepted when they arrive. Ask for declarations and test documents by drawing number: a certificate naming a sales model and a schedule naming a drawing are hard to reconcile at handover.

State the pre-shipment inspection requirement and who attends it, so the record exists before the container is sealed. Then specify label, packing and pallet marking against the installation sequence, so cartons reach the right floor without being opened to find what is inside.

Releasing the RFQ so every reply is comparable

The list only works if all of it reaches every bidder. Four habits make the replies comparable:

  • Send the same package to every bidder, and note what is not included.
  • Number the questions and ask for numbered answers, so a gap is visible rather than buried in prose.
  • Ask what the supplier has excluded, the single most useful line in any quotation.
  • Fix a reply date and hold it: late replies often come from bidders who read the scope most carefully.

Then compare on scope rather than on total: two quotes that differ by a percentage may simply cover different packages.

Reading the replies without re-opening the scope

The reply is where an RFQ either holds or dissolves. Check each bidder against the numbered questions before looking at price, and treat a blank answer as a question rather than a saving.

A supplier can only be held to the gaps the RFQ left open. Every detail you leave out is one you will negotiate later, with less leverage and a shorter clock.

If two replies land close on scope and far apart on price, the difference is normally in the parts nobody can see: the driver, the plating, the packing. Ask both for the component list against the drawing.

FAQ

How long should an RFQ for a hotel lighting package be?

Long enough to answer the eighteen points above, and no longer. A schedule, a drawing set, a finish list and numbered requirements cover most packages. Length is not the measure; completeness is.

Should the RFQ go out before the finish samples are approved?

Yes, provided the finish is described by process rather than by photograph and sample approval is named as a gate on production. Sending it earlier buys schedule; sending it with a colour name only buys a later argument.

Who states the light output and colour temperature?

The project lighting designer, confirmed against the standard for that location. The supplier's role is to meet the stated range.

Do we need a mock-up room for a small package?

Not always. A single approved sample will carry a standard fixture, while custom work, unusual dimensions or a first order with a new supplier benefits from a room reviewed in real conditions.

What if a supplier refuses to state their exclusions?

Treat it as a warning. A supplier who will not describe the boundary of their offer has either not read the package or does not intend to be held to it.

The takeaway

Change orders are usually written before the order, in the RFQ that went out without them. Spend the extra afternoon on the four lists, and the same eighteen details do something useful: they make five replies comparable, and they keep the negotiation at the quoting stage, where you still have choices.

Zerouno Lighting (ZeroUNO) manufactures hospitality decorative lighting in Zhongshan, China, and has built project and custom fixtures since 2013. Custom enquiries normally start with a one-piece sample against the drawing, and made-to-order work typically runs 25 to 35 days once the sample is approved. Learn more at zerounolighting.com.

About the author

Sonny Yu is Sales Manager at Zerouno Lighting, working with designers and procurement teams on hospitality lighting packages. Much of his week goes on reading the specification, the schedule and the quotation against each other, and finding the detail the three describe differently.
